Our Work

2012-2018

website builder

2015-2018

OJSC "Rostelecom"

Construction of broadband access using PON FTTH technology in Krasnodar Region, Rostov Region, and Stavropol Region of Russian Federation.

34,256 households have been connected using general construction way. 1136 km of fiber optic communication lines have been laid. Construction speed - 1 km per day.

27,282 households have been connected using the trench method. 2325 km of fiber optic communication lines have been laid. Construction speed – 3 km per day.

32442 households have been connected using HDD method. 13,400 km of fiber optic communication lines have been laid. Construction speed - up to 8 km per day.

12289 households have been connected by means of suspending the lines on the lighting poles. 689 km of fiber optic communication lines have been laid. Construction speed - 3 km per day.

2016-2018

LLC “GazpromTransgaz”

LLC “Kubanenergo”

LLC “Lukoilenergoseti”

Construction of fiber optic communication lines in Rostov region, Stavropol and Krasnodar Region. 1800 km. Construction of technological communication lines and main pipelines.

2016-2018

PJSC "Rostelecom"

Construction of fiber optic communication lines in order to connect hospitals in Rostov, Volgograd regions and Republic of Kalmykia. 768 hospitals have been connected. Most of the work was done using HDD method.

2017

PJSC "Megaphone"

Construction of fiber optic communication lines in the Kabardino-Balkarian Republic and Rostov region. 260 km. Construction of technological communication lines and main pipelines.

2014-2016

PJSC "Vimpelcom"

Construction of fiber optic communication lines in the Kabardino-Balkarian Republic and Rostov region. 370 km. Construction of technological communication lines and main pipelines. Construction of DWDM equipment

2017-2018

Airport "Khrabrovo", Kaliningrad

"The second phase of reconstruction and development of the airport ‘Khrabrovo’, the city of Kaliningrad, Kaliningrad region." Cable lines construction using HDD method. Diameter is 315 mm, 355 mm, 400 mm, 500 mm, 710 mm, 900 mm. The total length is 1400 m.

2016-2017

PJSC "GAZPROM"

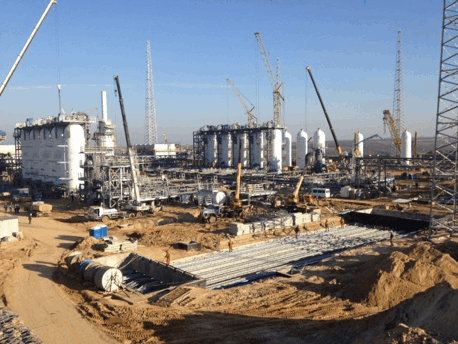

“Terminal for receiving, storing and regasification of Liquefied Natural Gas (LNG) in the Kaliningrad Region. Cofferdam at sea for laying 10kV cable lines”. Trenchless laying of a steel case for the subsequent laying of the CL 10 kV power cable in the case using HDD method.

2016-2018

PJSC "GAZPROM"

"Gas pipelines for gas supply of newly constructed power plants in the territory of Kaliningrad region" as part of "Gas pipelines for gas supply of newly constructed power plants in the territory of Kaliningrad region" construction project. Connection facilities construction using HDD method. Length is 2570 m. Diameter is 63 mm, 325 mm, 630 mm, 720 mm. Installation of automation and telemechanics systems, fiber optic lines with a total length of 85 km.

2016-2018

PJSC "GAZPROM"

“Reconstruction of existing facilities and construction of new water-brine complex facilities, water intake and brine discharge into the Baltic Sea of the Kaliningrad UGS in order to get the design active volume of 800 million cubic meters”. Connection facilities construction using HDD method. Length is 4670 m. Diameter is 110 mm, 400 mm, 630 mm, 820 mm, 1020 mm. Installation of automation and telemechanics systems, fiber optic lines. Installation of the main fiber-optical lines with a total length of 21 km.

2016-2018

PJSC "GAZPROM"

“Land gas pipeline with facilities included in the infrastructure of a linear facility” as part of “Terminal for receiving, storing and regasification of Liquefied Natural Gas (LNG) in the Kaliningrad Region” construction project. Connection facilities construction using HDD method. Length is 4360 m. Diameter is 630 mm, 820 mm. Installation of automation and telemechanics systems, fiber optic lines. Installation of the main fiber-optical lines with a total length of 44 km.

2016

Kaliningrad Administration

Construction work using the trenchless method. Building of the gas pipelines’ sections with a diameter of 630 mm, No. 2 diameter of 530 mm, and - construction of the electrochemical protection complex. Sections are installed across the left and right tributaries of the Pregol River. Gas pipes and protection complex fall into the construction zone of engineering infrastructure for the World Football Cup in Kaliningrad.

2015

Kaliningrad Administration

"Construction of household sewage discharge collector of Kaliningrad." The construction method is microtunnelling. The length of the collector network is 750 m. Depth of laying - up to 8 m.

2014-2016

PJSC "GAZPROM"

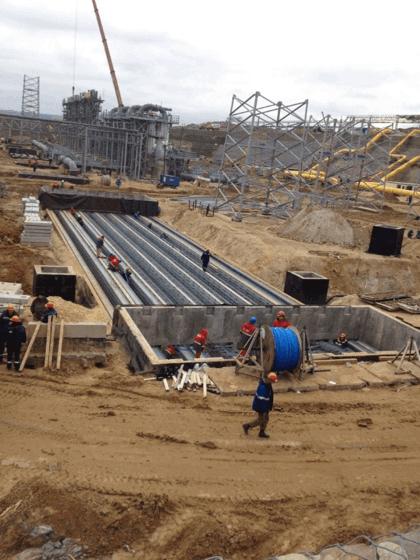

“Kazachya” CS as part of the “UGSS expansion in order to ensure gas supply to the ‘South Stream’ gas pipeline”. Installation of fiber optic lines, power supply networks, installation of gas turbine plants automatics, installation of automation and control systems of the Gas-to-transport plant. The total length of all cable lines is 4235 m.

2014

Kaliningrad Administration

"Reconstruction of the waterfront protection structures in Kaliningrad." Engineering networks installing, SPS building and 5 drainpipe crossings over the Pregolya river using the HDD method.

2014

Kaliningrad Administration

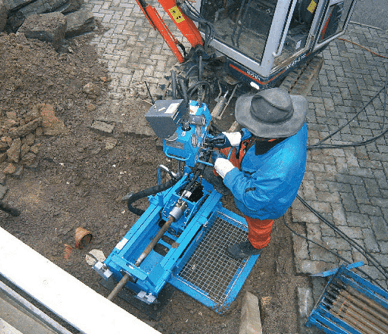

"Construction of the water pipe with diameter of 500 mm in Kaliningrad". Water pipe installing using microtunneling method. Length = 130 m.

2013

Kaliningrad Administration

"Construction of sewage collector for the complex development of the South-Eastern residential district of Kaliningrad." Installing using HDD method. The length of the network is more than 4,000 m. 1,700 meters are laid under water.

2012

JSC "Rosmorport"

"Power supply reconstruction of stationary navigation signs of the Kaliningrad Sea Canal". Laying of the cases for the power cable using the HDD method. The length of the network is 2073 m. Network is laid across the canal at a depth of up to 18 m, the average length of single drilling is 350 m.

2012-2013

Kaliningrad Administration

"Construction of external sewerage network with diameter of 1000 mm in Kaliningrad”. The construction method is microtunnelling. The network length is 1,036 m.
